Sackville Street, Mayfair

Main contractor · Sackville Street, Mayfair, W1 · Period office building with residential upper floors, four office floors and eight flats above. · Painting and decorating throughout: four office floors, eight flats, lobbies, stairs, basement and terrace, in phases for the main contractor · Three years in phases, 2022 to 2024. · Credits below

A period building on Sackville Street, off Piccadilly: four floors of offices with eight flats above. In March 2022 the floors were bare plaster. We were the decorating contractor through every phase that followed. The offices came first, then the flats, then the communal areas. The last photographs are from the summer of 2024. The main contractor was Pryer Construction.

The brief

The March 2022 photographs show open floors with bare plaster, exposed joists and no services. The main contractor needed one decorating contractor for the building, phase by phase. The first phase was the office floors, the toilets, the hallways and lift lobbies and the basement. The second was the eight flats and the residential hallway, with a terrace outside. A third sheet covered the making good after the other trades: 37 access hatches, plastering in one flat, ceilings and walls repaired after the kitchen fitters and the electricians. We priced each phase on its own and the main contractor instructed each one separately. The building was a live construction site throughout, not an occupied one. Everyone on it went through the main contractor's induction, and the main contractor managed access and egress.

Our approach

One specification across every area, so the building reads the same from the basement to the top flat. We mist coated the walls and ceilings on the bare plaster, then filled and fine filled. The ceilings took two coats of Tikkurila Anti Reflex White (2). The walls took two coats of Dulux Trade Diamond Matt, RAL 9016 on the office floors and a tinted colour in the flats. We filled the woodwork, caulked every junction with the wall, sanded it and finished it in Dulux Diamond Eggshell, with Dulux Diamond Satinwood where the specification called for it. Three of the flats came to us with the old wall coverings already stripped. We sanded those walls through ascending grades first, so the change in texture between filler and plaster did not show through the finish.

On site

Phase one ran through the office floors while the building was still a site. The May 2023 camera photographs show the office floors, the lift lobbies and the reception finished. Phase two moved to the flats behind the other trades. We prepared and painted the access hatches. We repaired and repainted ceilings and walls after the kitchen fitters and the electricians. We painted the fire escape doors black, and the cleaners' and electrical cupboard doors in French grey. About three quarters of the way through the contract the main contractor asked us to price the external steel fire escape as an extra, and we won it. We took the failed coatings back to sound metal mechanically, section by section behind protection and with dust extraction on the removal. We primed the stair in Rust-Oleum CombiPrimer Anti-Rust Primer, finished it in Rust-Oleum CombiColor and picked out the nosing of every step in an anti-slip paint. The June and August 2024 photographs show the residential lobbies, the stairs and the flats finished. We finished the building in a set order. The metal louvre at the top came first, then the office floors, then the flats and the hallway together. After those came the communal area downstairs, then the metal stairs at the back and the shower room in the basement last of all. The communal areas came last overall.

The result

Four office floors finished, eight flats decorated and communal areas that carry the same finish from the reception to the top landing. We photographed the reception, the lift lobbies and the office floors in May 2023, with the walnut, brass and marble in place. We photographed the flats and the residential lobbies in June and August 2024. The same two matt finishes run through every one of those rooms, which is what one specification across a building looks like at the end. The building is now fully occupied.

Photographs

Reception at Sackville Street with walnut slatted panelling, a brass handrail on the steps and two armchairs on a marble floor
The reception, May 2023. Walls and ceiling in the same matt system as the office floors; the walnut, brass and marble are other trades
Walnut lift lobby wall with a brass Sackville Street sign and the number 4 for the floor
A lift lobby sign in walnut and brass. The lift lobbies and hallways were in the first phase of the painting; we painted and whitewashed them first, the joinery went in after us and we came back to paint them again
Lift lobby with marble walls, walnut slats, brass lift doors and a lit cove to the ceiling
A lift lobby ceiling and cove finished in Tikkurila Anti Reflex White (2), so the concealed lighting reads as an even line with no flashing
Open office floor with white columns, a grey tiled floor and windows along the far wall, May 2023
An office floor in May 2023, walls in two coats of Dulux Trade Diamond Matt in RAL 9016 and ceilings in two coats of Tikkurila Anti Reflex White (2), both over a mist coat on the bare plaster

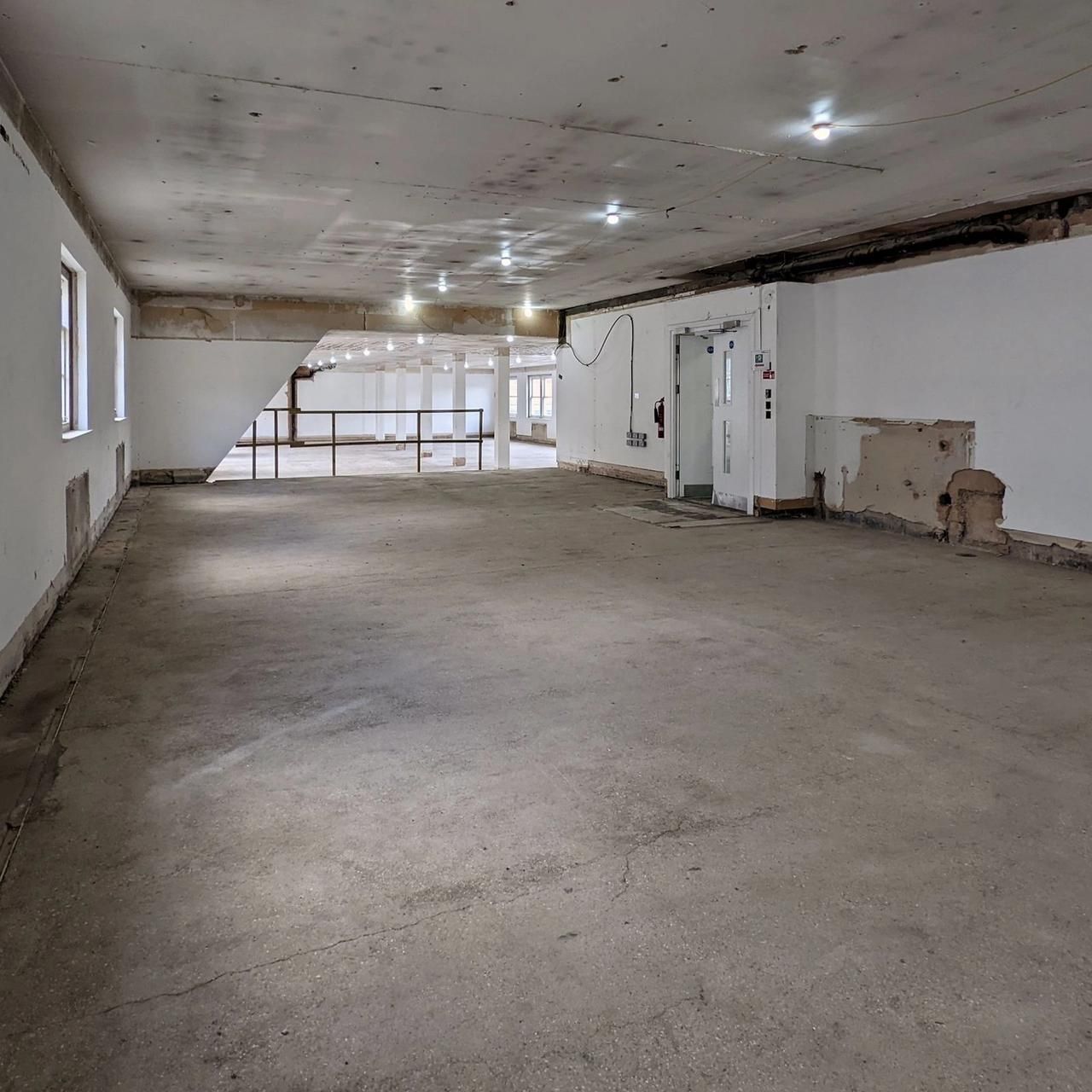

An office floor stripped to bare plaster with exposed joists and no services, March 2022
March 2022, before the first phase: bare plaster, open ceilings, the floor waiting for services. The office floors on this page were painted from this state

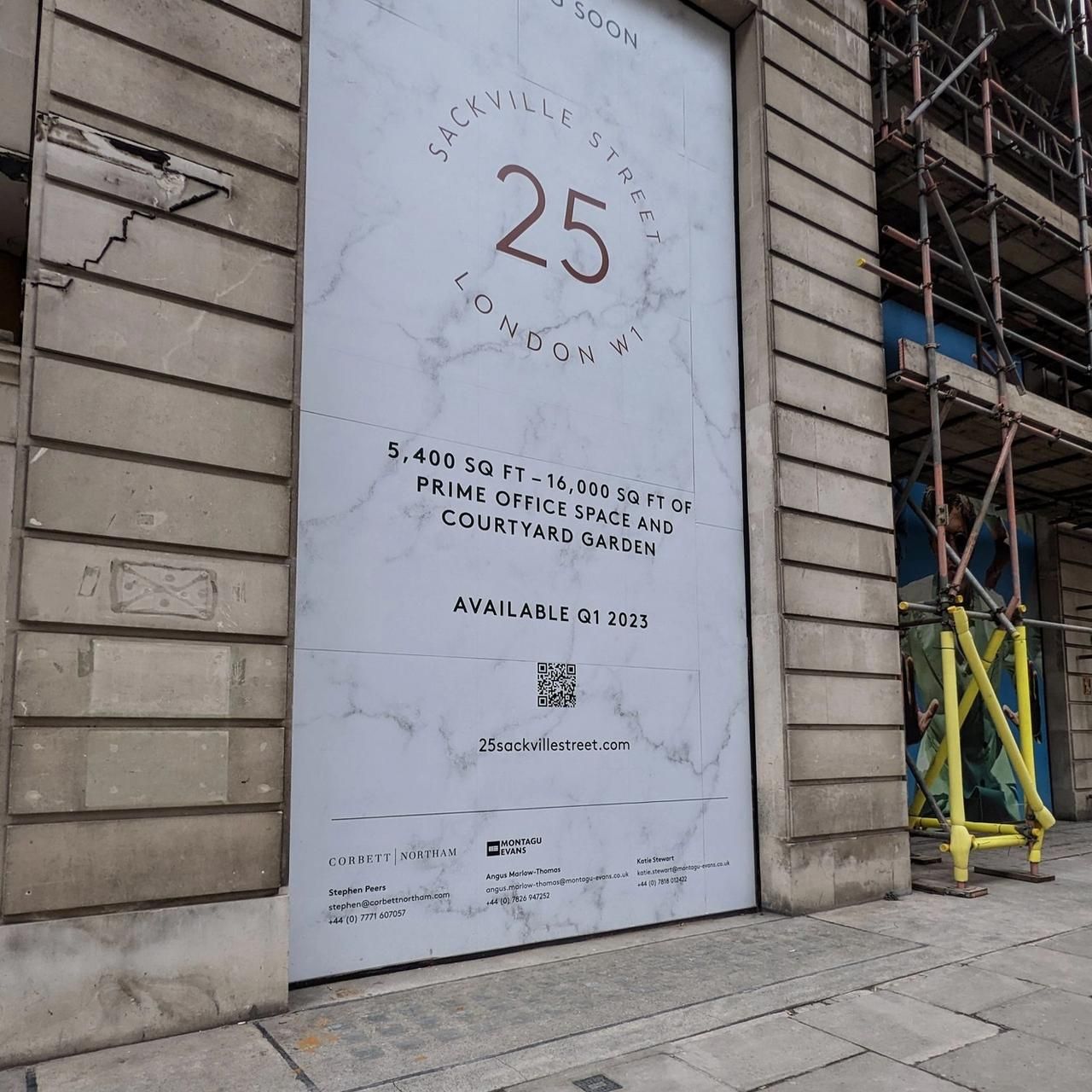

Scaffolded stone facade on Sackville Street with a Sackville Street letting board, November 2022
The building under scaffold in November 2022, part way through the first phase, with the agents' board already up for the offices
Finished office floor with grey polished floor, white columns, an easel with plans and sash windows, September 2023
An office floor in September 2023, with architectural plans on an easel by the window, showing the uniform paint specification carried across all four commercial levels
Black flat entrance door with a vertical glazed panel in a grey painted lobby with fire safety signage
A flat entrance in the residential lobby, June 2024. Walls and ceiling in the tinted Diamond Matt used through the flats; the pre-finished entrance fire doors were supplied and installed by others
Cloakroom in one of the flats with white tiling, a round mirror and a timber floor
A flat cloakroom, June 2024: walls and ceiling finished after the plumbers, with the making good after the other trades carried in our scope on the extra sheet

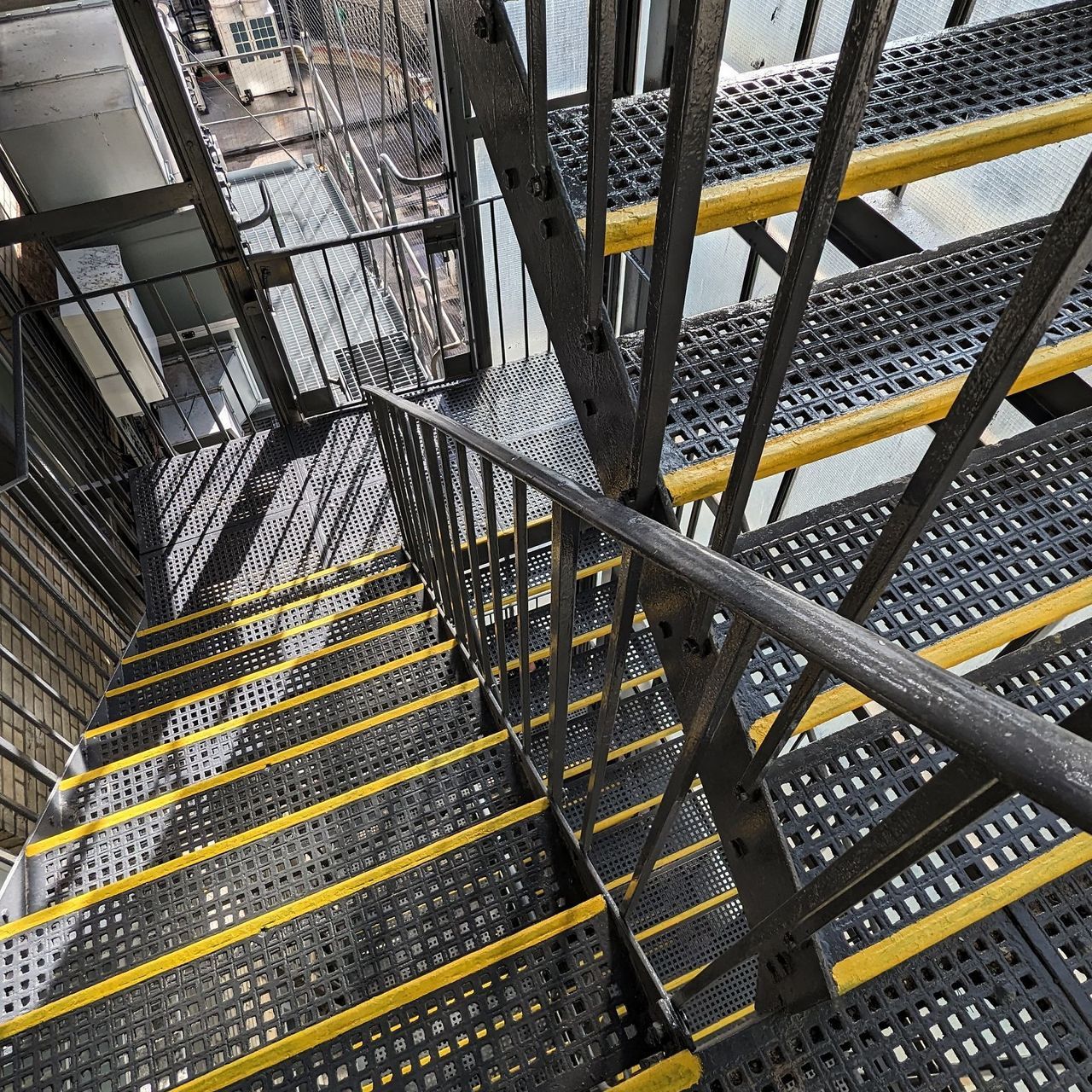

External steel fire escape stair with yellow tread edges seen from above
The external fire escape, October 2023. The doors were painted black in the second phase. The stair itself came later as a priced extra: failed coatings off, primed in CombiPrimer Anti-Rust Primer, finished in Rust-Oleum CombiColor and the step nosings picked out in anti-slip paint
Reception with an abstract artwork on a white wall, walnut slatted screen and steps with a brass rail
The reception from the entrance, May 2023. One matt finish on the walls so the artwork and the walnut carry the room
